Serving Myrtle Beach, Carolina Forest, North Myrtle Beach, Conway, Surfside, Murrells Inlet, Pawleys & the Grand StrandWe answer 24/7 · (843) 233-9716
(843) 233-9716

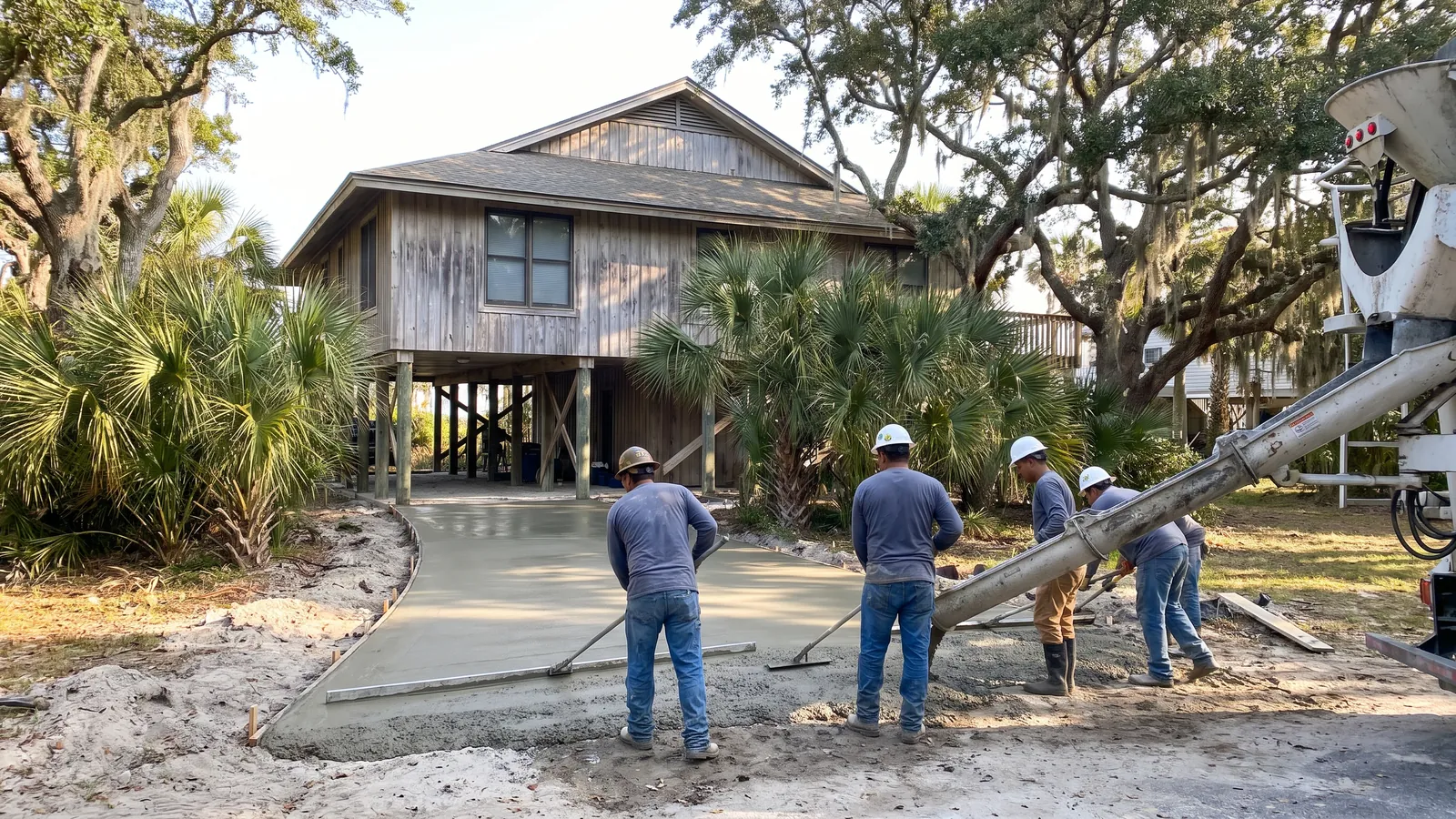

Concrete crew screeding a new broom-finish driveway at a raised coastal home with palmetto palms in Myrtle Beach, South Carolina
Myrtle Beach · Carolina Forest · North Myrtle Beach · Conway · Surfside · Murrells Inlet · Pawleys

Concrete that holds up on sand, salt air and a high water table — poured by people who know whose road it's on.

Driveways and aprons with the right permit for the road, patios and pool decks, stamped concrete, golf cart pads and paths, shed and generator pads, foundations, repair, leveling and removal across the Grand Strand — compacted base, reinforcement that doesn't rust, and an itemized written price before the truck is ordered.

Insured crews · City of Myrtle Beach, Horry County and SCDOT permits handled · SC 811 before every dig · Free estimates

6 in · 3,000 psiThe City of Myrtle Beach apron spec — fiber mesh, five-foot radii, no wider than 20 ft at the property line
4 in minimumHorry County's residential driveway spec in a county right-of-way, with a free encroachment permit and 72 hours' notice
12 in · 0.40 w/cFooting depth below undisturbed grade, and the water-cement ratio we hold for salt-air exposure within reach of the ocean
811 · 3 daysSC 811 marked three working days before every excavation, pad or stump — it's the law and we don't skip it
What we do

Twelve kinds of concrete for a beach town built on sand

Under the slab

What's between your driveway and the water table

A concrete slab on the Grand Strand is only as good as the four inches of sand under it and the rules about where the water goes. Here's the cross-section we build to, top to bottom, and why each layer is there.

LayerWhat we useWhy, on the Grand Strand

SurfaceBroom finish, smooth border, or stamped with integral color and a UV-stable sealerBroom for grip when it's wet; sealer because beach sun and salt bleach cheap color in two summers
Slab4 in residential (6 in at the city apron, boat and RV pads), 3,000–4,000 psi, air-entrainedThe city's apron spec is 6 in / 3,000 psi; 4,000 psi and a 0.40 water-cement ratio within reach of salt spray
ReinforcementFiber mesh, or epoxy-coated rebar on chairs for structural work; never bare mesh lying on the sandThe city requires fiber only in aprons; bare steel near the ocean rusts and spalls the slab from inside
JointsControl joints at 8–10 ft, expansion joint at the property line and against the house and the garageSand lets slabs move a little; joints decide where the crack goes
Base4 in of compacted crusher run or clean sand, plate-compacted in lifts, on undisturbed or compacted subgradeUncompacted beach sand is why driveways here sink at the apron and crack at the garage
DrainageGrade away from the house, swale and ditch flow preserved, pipe in the ditch where the county says soHorry County's stormwater ordinance forbids blocking a swale to a neighbor's detriment; NMB wants approval for more than 8 in of fill

Why concrete sinks here →   Permits by road owner →

By the numbers

Three numbers that decide most Grand Strand concrete jobs

21.8%

Horry County's growth since 2020

From 351,000 people to 427,551 in five years, the fastest-growing part of the Carolinas — 6,511 building permits in 2025, Carolina Forest grown from 3,400 people to 23,000 since 2000, and a third of the county past 65. New homes need first driveways; the 1970s–90s stock that makes up 42 percent of the city needs its second.

20,613

Short-term rental listings in Myrtle Beach

Every one of them needs off-street parking, and North Myrtle Beach's 2021 rules say it has to be fully on private property, not on the sidewalk or in the landscape bed. Parking pads, widened drives and cart pads for rental houses are a steady part of our week.

21.16 ft

The Waccamaw's record crest at Conway, 2018

Florence dropped 23.63 inches on Loris and put the river three feet over Matthew's record. A quarter of the county is in the 100-year floodplain and the 2021 FEMA maps added 10,500 parcels. Where the water goes decides how we grade, whether we can add fill, and how high a slab has to sit.

Flood zones and concrete →   Golf cart pads and the law →

What fails here

Four things that keep our phone ringing

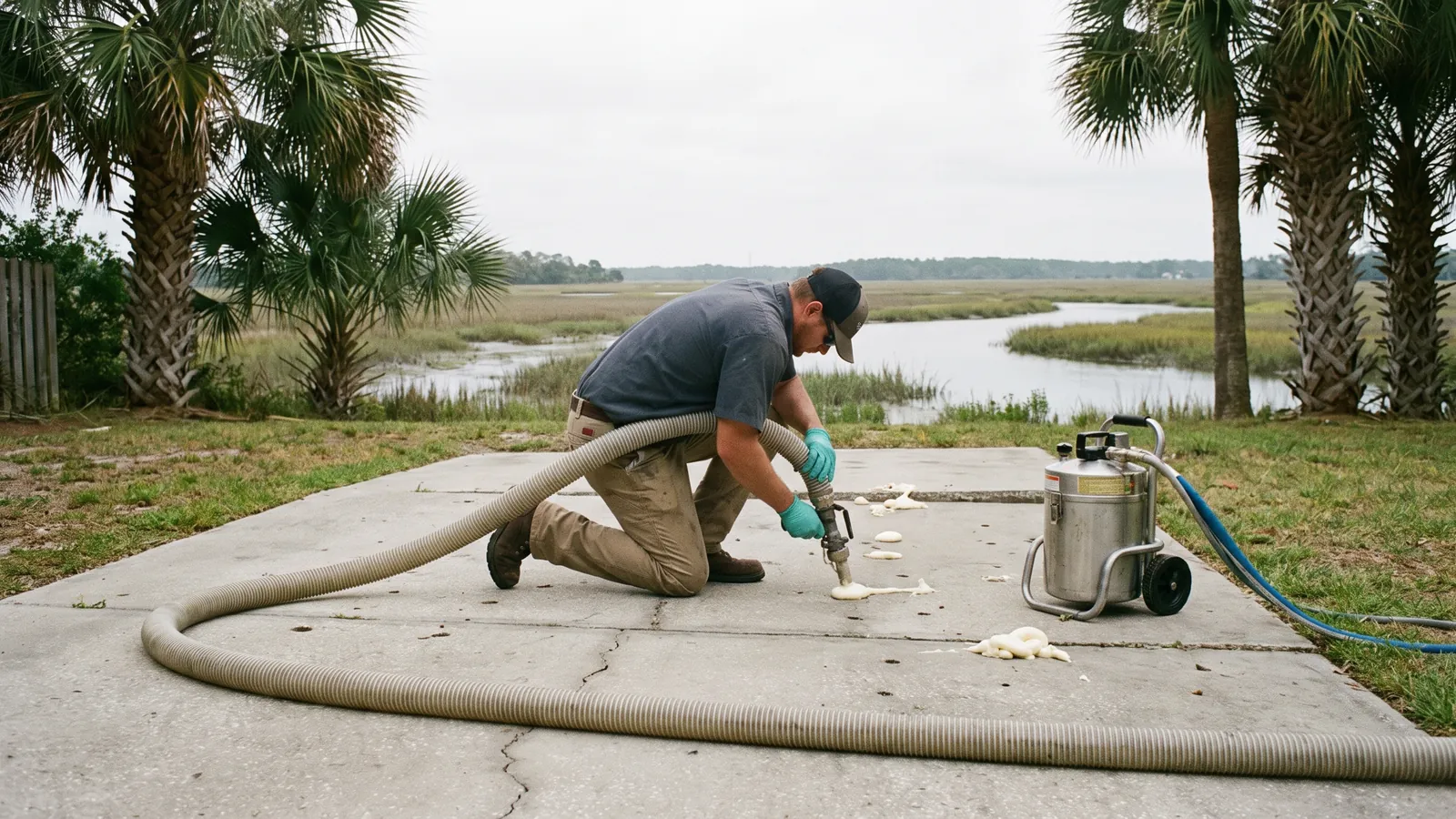

Technician injecting polyurethane foam through small holes to lift a sunken concrete driveway slab at a coastal home

1970s–90s driveways

The sunken apron

The driveway settles where it meets the street, because the original builder poured on loose sand over the trench for the utilities. It can often be foam-lifted; sometimes the apron is replaced to the city's six-inch spec.

Leveling →

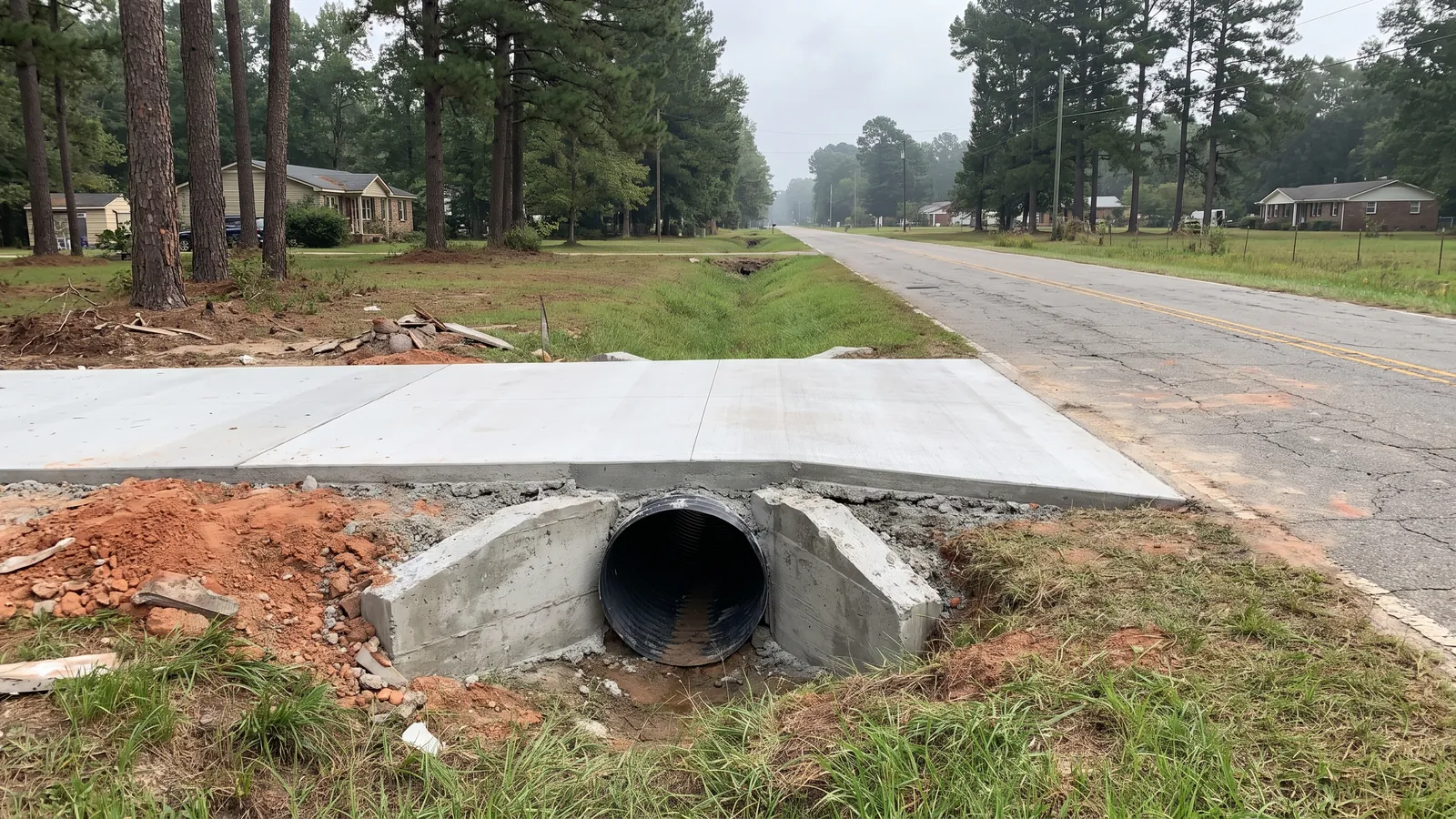

New concrete driveway apron crossing a roadside drainage ditch on a culvert pipe with poured end sections on a Horry County road
County roads

The crushed culvert

A driveway over a roadside ditch on a pipe that was too small or too shallow. The pipe collapses, the apron drops, and the ditch backs up into the neighbor's yard — which the county's stormwater ordinance makes your problem.

Culverts →

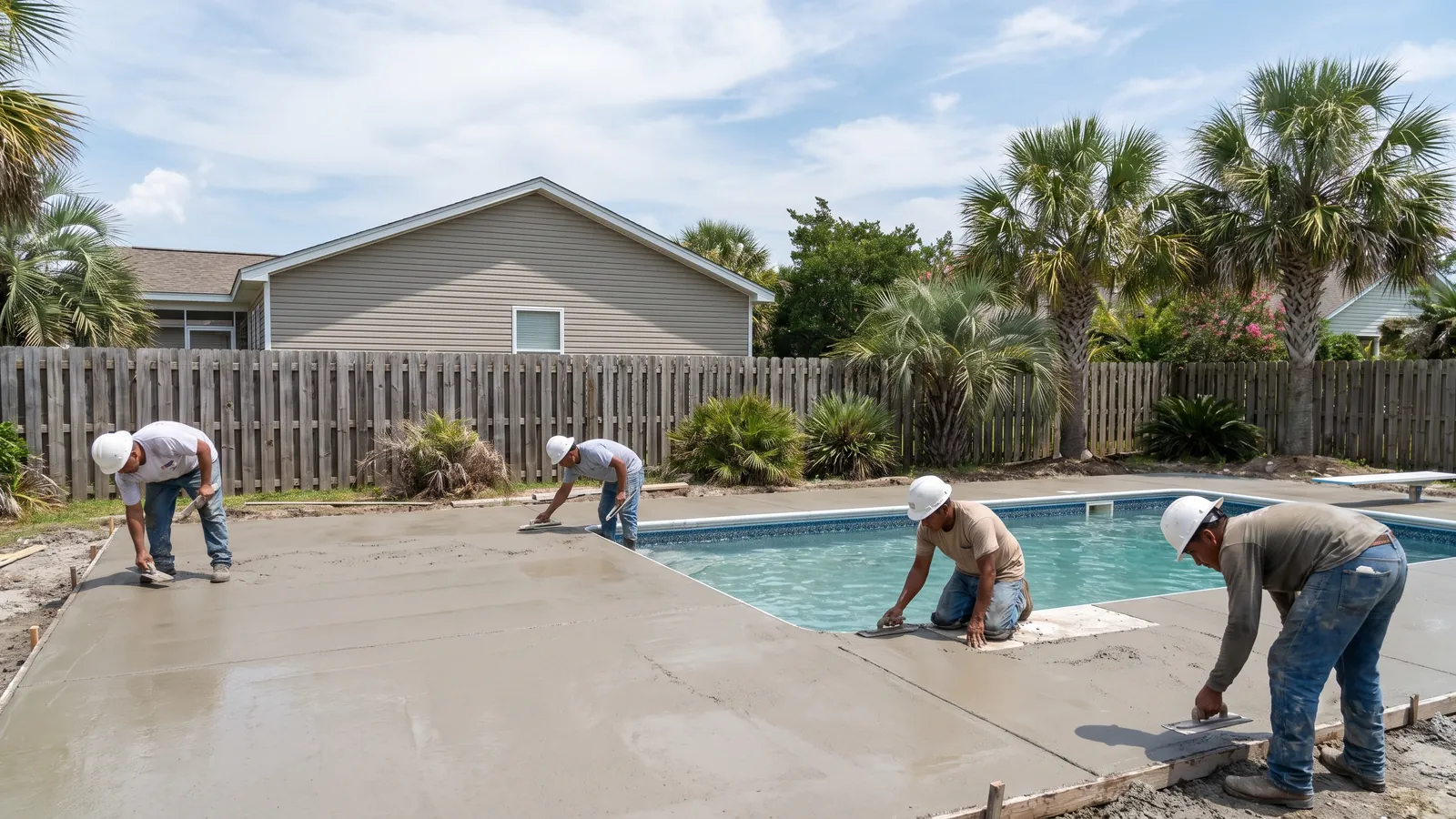

Crew finishing a fresh concrete pool deck around a backyard pool at a South Carolina coastal home under a bright sky
Within a mile of the beach

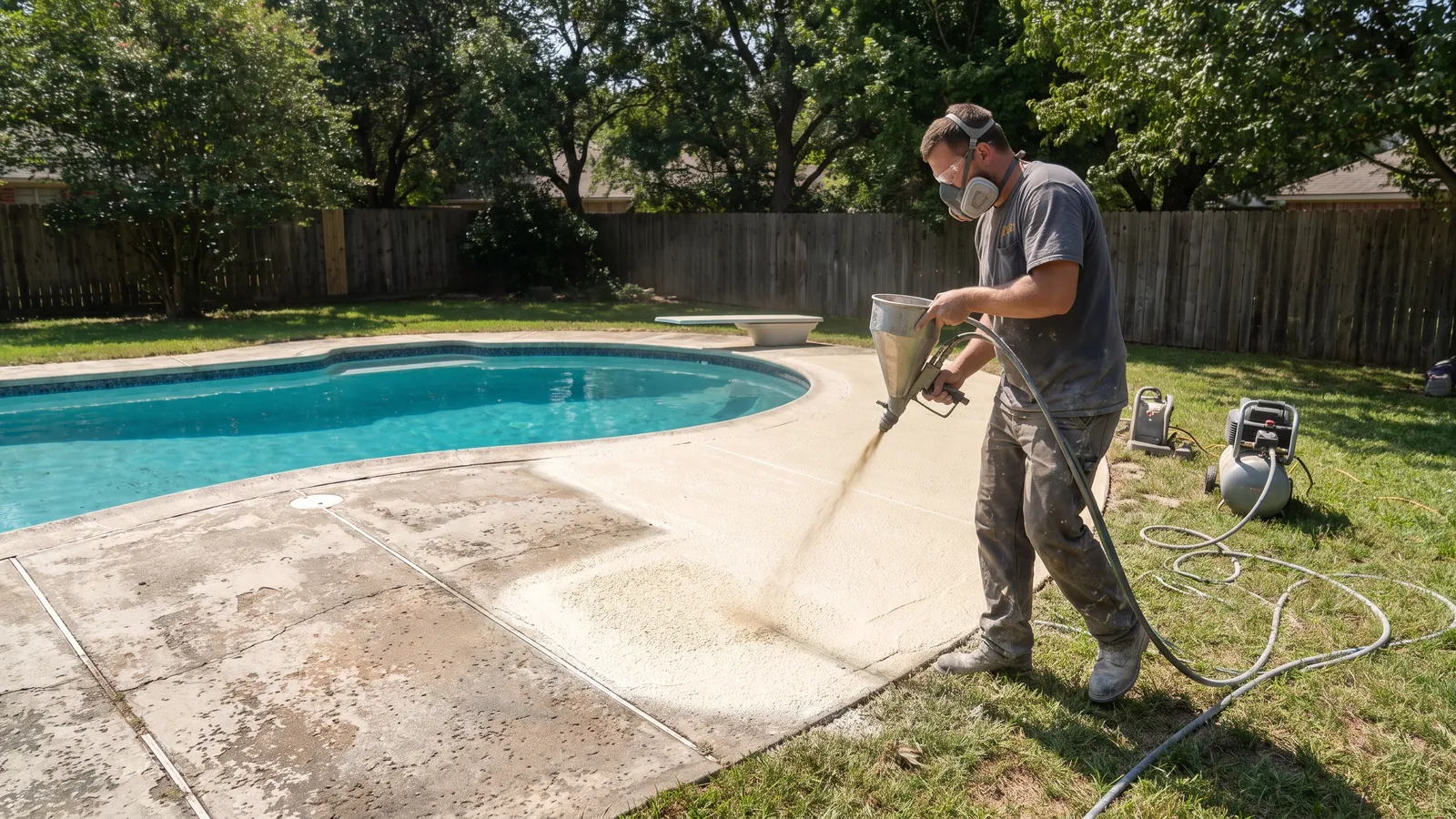

The rusting pool deck

Bare wire mesh laid on the sand instead of chaired in the slab, and the salt air found it. Rust expands, the surface spalls in sheets, and the deck has to be resurfaced or replaced.

Resurfacing →

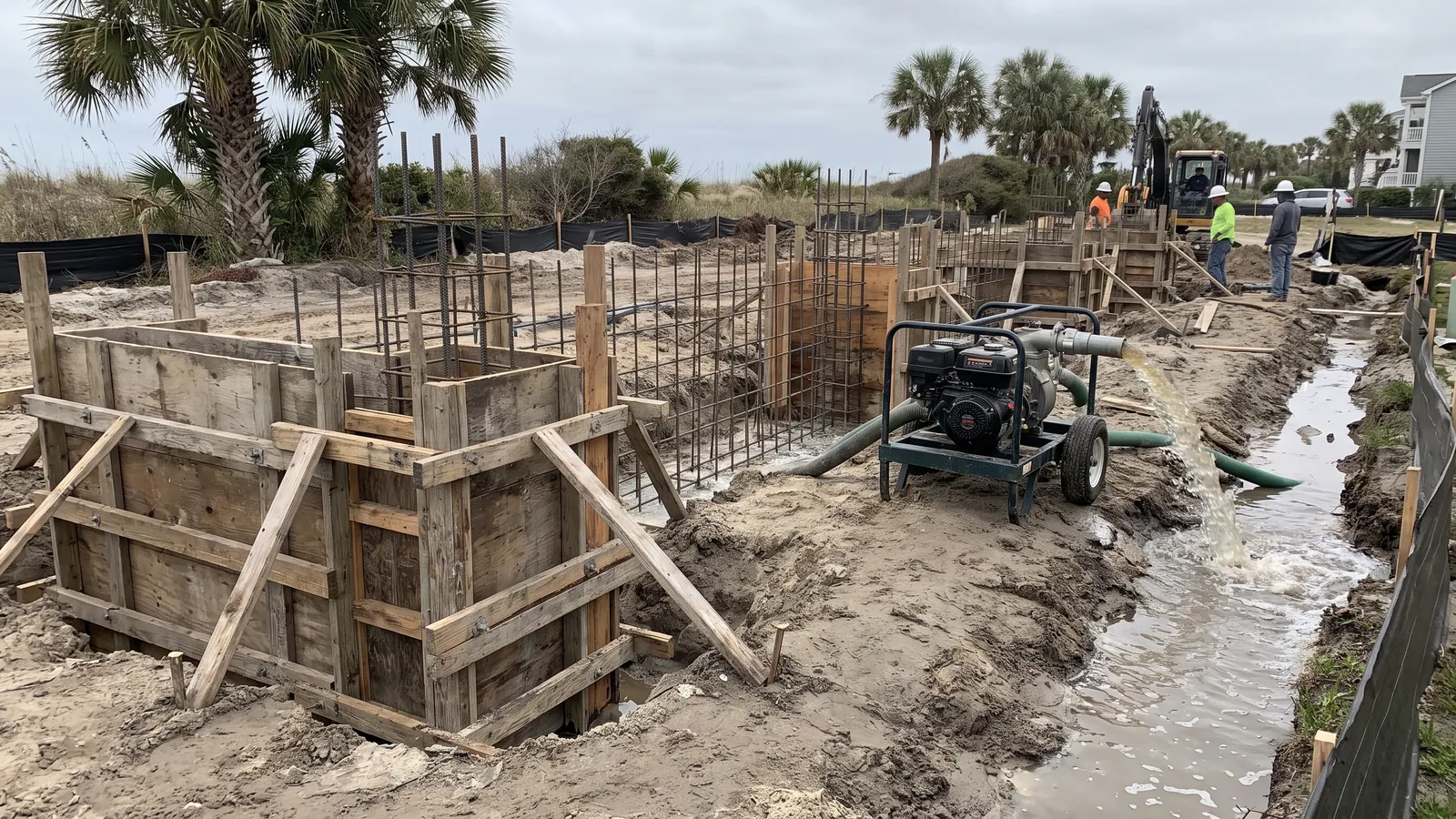

Reinforced concrete footing and stem wall forms with rebar in sandy coastal ground, water pumped from the trench, ready for a pour
Conway & the river

The heaved slab

West of the Waterway the soils turn to clay — Bladen, Meggett, Yauhannah — that swells wet and shrinks dry. A shed slab or an addition poured without a prepared base lifts in the wet season and cracks in the dry one.

Foundations →
Aerial view of the Grand Strand with rows of beach homes, dunes, the Intracoastal Waterway and the Atlantic Ocean
Why local matters

The Grand Strand is sixty miles of beach on sand, water and three different sets of rules

Myrtle Beach sits on a Pleistocene barrier complex — the sand ridges that pushed the Pee Dee, Waccamaw and Black rivers south to Winyah Bay — and everything east of the Intracoastal Waterway is built on it: excessively drained dune sand on the ridges, poorly drained Leon sand with a hardpan and a water table a foot or two down in the flats between. Cross the Waterway toward Conway and Carolina Forest and the ground changes to the clayey Bladen and Meggett soils of the river terraces, and to the four hundred Carolina bays — more than any county in the state — with their peat bottoms. The county's own planning documents say the majority of its soils are poorly drained loamy sands, that 88 percent have severe septic limits and that a quarter of the land is in the 100-year floodplain. None of that stops concrete; all of it decides how we build it.

Then there's who owns the road. Horry County maintains 1,425 miles of its own roads, SCDOT another 1,500 miles of state and US highways through the county, and the cities — Myrtle Beach, North Myrtle Beach, Conway, Surfside Beach — the streets inside their limits. A driveway apron is permitted and inspected by whichever of them owns the pavement, and the specs differ: the city wants six inches of fiber-mesh concrete at 3,000 psi with five-foot radii and a form inspection; the county wants four inches, expansion joints a foot either side of the pipe, and a one-year warranty on a free encroachment permit with 72 hours' notice; SCDOT wants its own encroachment permit. Then the HOA in Carolina Forest wants a surveyor's plat with the application, and Barefoot's review committee decides driveway widenings case by case.

And the water. Hugo's thirteen-foot surge took 43 percent of Garden City's beachfront in 1989; Floyd dropped almost fifteen inches on Myrtle Beach in 1999; Matthew and then Florence put the Waccamaw at Conway over its banks for weeks, Florence at a record 21.16 feet in 2018; Isaias came ashore just up the coast in 2020, Ian at Georgetown in 2022, and Debby put seventeen inches on Loris in 2024. We grade every slab to send water away from the house without sending it next door, we pipe the ditch where the county says so, and we don't add fill in a flood zone without the approval it needs. The boring parts are the job.

How it works

Five steps from the call to the cure

1

Call or send the form

A cracked driveway, a new house that needs its first apron, a cart pad for the rental — tell us what you're after. We answer around the clock.

2

We measure and look at the water

Usually within a day or two: square footage, the ditch or swale, the slope, where the truck can park, and whose right-of-way the apron is in.

3

Written, itemized price

Base, thickness, reinforcement, finish, joints, removal, the permit and its inspections — every line, good for 30 days. No deposit until you approve.

4

Permit, 811, forms, inspection

We pull the encroachment or apron permit, SC 811 marks the yard, forms go in, and the city or county inspects before the pour where they require it.

5

Pour at first light, cure a week

Pours start early to beat the heat and the afternoon storms. Walk on it the next day, park on it in seven, and we come back to cut the joints and seal if specified.

Where we work

From Little River to Pawleys Island, and inland to Conway, Loris and Aynor

We're across Myrtle Beach every week — the Grande Dunes and Arcadian Shores end, the oceanfront and Pine Lakes, Market Common and the south end, Forestbrook and the 501 corridor — and across the Waterway in Carolina Forest, where the new neighborhoods are and the HOAs want a plat with every application.

Up the Strand we cover North Myrtle Beach, Little River and Longs; inland Conway, Red Hill, Socastee and Burgess, Loris and Aynor; and down the coast Surfside Beach and Garden City, Murrells Inlet, and Pawleys Island and Litchfield in Georgetown County.

See the full service area →
The Myrtle Beach Concrete Co. crew in front of a ready-mix truck and their pickup on a Myrtle Beach street
Straight answers

Questions Grand Strand homeowners ask us

How much does a concrete driveway cost in Myrtle Beach?

In 2026 a plain broom-finish driveway on the Grand Strand runs about $6 to $10 per square foot installed, reinforced — so a typical two-car driveway of 500 to 650 square feet lands between $3,500 and $6,500, and a long drive to a raised beach house with an apron and a culvert can reach $10,000 to $15,000. Stamped or colored work is $12 to $20 per square foot. Tearing out an old driveway adds $1.10 to $1.80 per square foot plus the landfill's $15-a-ton concrete fee. Every price we give is in writing after we've measured the site and checked where the water goes.

Do I need a permit for a driveway in Myrtle Beach?

It depends on whose road you're on. Inside the City of Myrtle Beach, anything in the street right-of-way — the apron — needs a permit from Construction Services, and the city's spec is strict: six inches thick, 3,000 psi, fiber mesh, five-foot return radii, no wider than twenty feet at the property line, a form inspection before the pour and a final after. In unincorporated Horry County the driveway itself is exempt from a building permit, but the apron, pipe or culvert in a county right-of-way needs a free encroachment permit from County Engineering with 72 hours' notice. On a state road — US 17, the Bypass, 501, SC 544, 31, 22, 9, 90, 701 — it's an SCDOT encroachment permit. North Myrtle Beach, Conway and Surfside have their own. We pull the right one before the truck is ordered.

Why do slabs sink and crack so much around here?

Sand, water and salt. Most of the Grand Strand sits on marine-terrace sands with a water table one to three feet down — the Leon soils under half the beach have a hardpan within thirty inches that holds water above it — and inland toward Conway the soils turn to clay that swells and shrinks. A slab poured on unprepared sand settles when the water moves the fines out from under it; a slab poured on wet clay heaves. Salt air finishes the job on anything with unprotected steel in it. The fix is boring: compacted base, fiber or coated reinforcement, a proper thickness, control joints, and drainage that moves water away from the slab instead of under it.

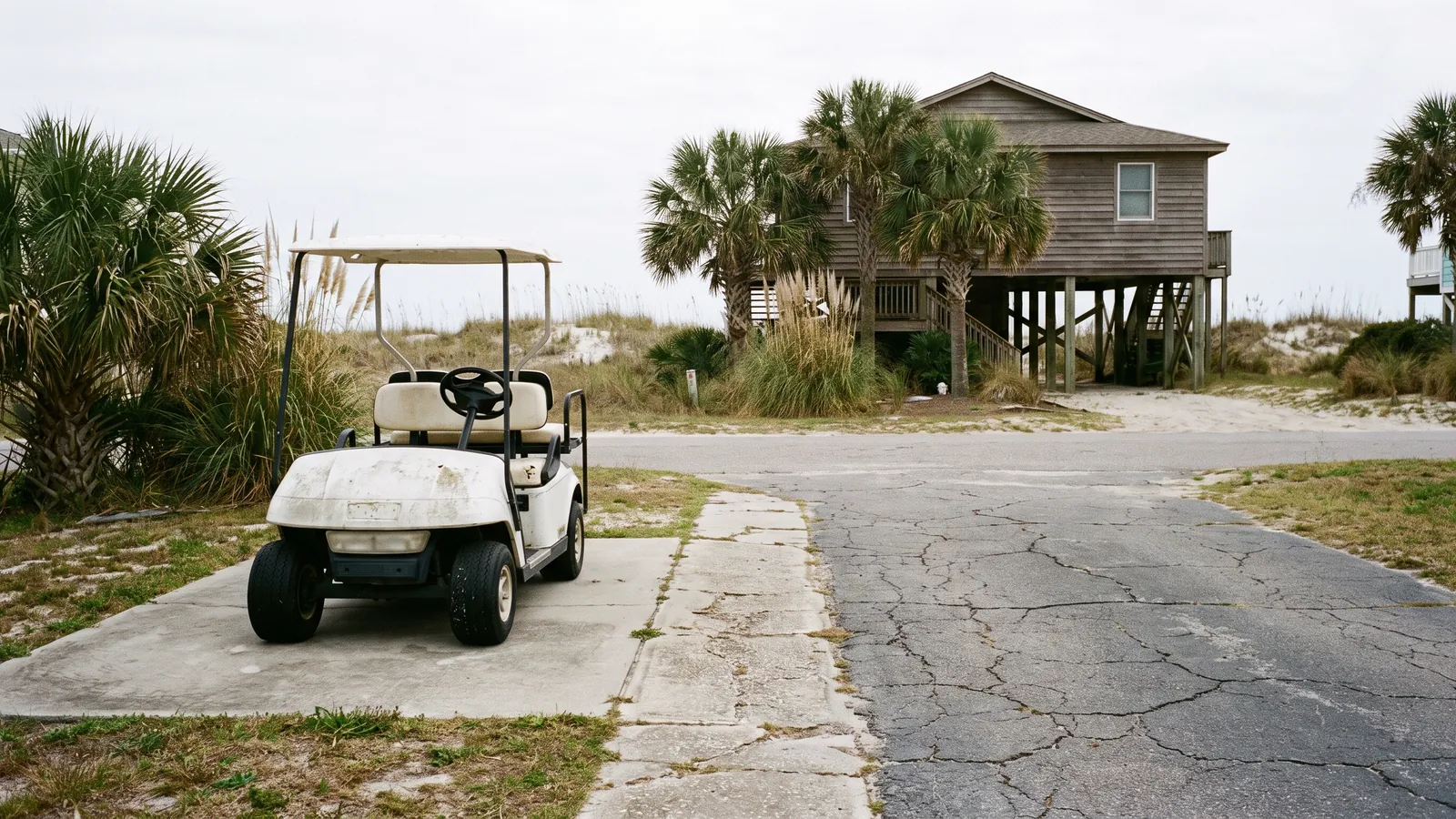

Can you pour a golf cart pad or path?

Yes, and it's one of the most common jobs we do. South Carolina lets a permitted golf cart run on roads posted 35 mph or less within four miles of the registered address in daylight, so most Grand Strand homes want a cart pad beside the driveway or a path to the street. A four-inch reinforced pad, usually six by twelve feet, runs $700 to $1,500; a path to the road is priced by the foot. HOAs in the golf communities usually need to approve it, and we handle the drawing.

Do you work in flood zones?

All the time — about a quarter of Horry County is in the 100-year floodplain and the 2021 FEMA maps moved more than ten thousand parcels into one. Flatwork like a driveway or a patio is fine in an AE zone; the rules bite on structural slabs and fill. The City of Myrtle Beach wants new living space three feet above base flood elevation, North Myrtle Beach a foot, and North Myrtle Beach also requires stormwater approval if a project moves more than eight inches of soil. We design around the zone instead of fighting it: elevated stem walls, flood vents, and no fill that sends water next door.

Do you really answer at night?

24 hours a day, every day. A person picks up, takes your details, and you hear from an estimator the next morning — usually with an on-site visit the same week.

Ready to pour something that lasts in the sand?

Free on-site estimate, an itemized written price, and the permit and drainage questions answered before the truck is ordered — anywhere on the Grand Strand.

Request an estimate
Call (843) 233-9716
